GOVCON WEEKLY
Canadian Procurement Pulse: Your Weekly Contractor Insider
Date: April 6th 2026

Most provincial budgets give you dollar amounts by ministry and leave contractors to guess where the work actually lands. Saskatchewan's 2026-27 capital plan is different. The SaskBuilds Major Capital Action Plan names the projects, the contractors who won them, the delivery models, and in many cases the completion dates. For a province spending $4.3 billion this year and $17.5 billion over four years, that level of transparency is a gift to anyone trying to figure out where to point their business development.
This edition breaks down the capital plan, overlays it with five years of SaskTenders data from Publicus, and identifies the contractors, buyers, and spending patterns that matter.
The Capital Plan at a Glance
Saskatchewan's $4.3 billion splits between two streams. Executive Government (ministries and agencies) accounts for $1.8 billion. Crown corporations (SaskPower, SaskEnergy, SaskTel, and others) account for $2.5 billion. This is Year 7 of the Growth Plan, which targeted $30 billion in infrastructure by 2030. Cumulative spend through 2025-26 has already reached $24.9 billion, and the province will significantly exceed the original target.
Stream | 2026-27 | 4-Year Total |
|---|---|---|
Executive Government | $1,795.7M | ~$6.9B |
Crown Corporations | $2,519.5M | ~$10.6B |
Total | $4,315.2M | $17.5B+ |
SaskPower alone is $1.67 billion of the Crown total, driven by coal-fired life extension (bridge to nuclear), transmission expansion, and system sustainment. The "bridge to nuclear" language signals sustained capital intensity well beyond this budget cycle as the province pursues small modular reactors at Estevan. Crown corporation procurement is largely invisible in SaskTenders, which means the $2.5 billion Crown sector operates through separate channels not captured in public data.
Health Infrastructure: $636 Million and the Contractors Are Named
Source: SaskBuilds Major Capital Action Plan | Budget 2026-27

What's Happening
Health is the largest Executive Government category at $636 million. The Action Plan names contractors, delivery models, and completion dates for every major project. This is unusually transparent for a provincial budget document.
Projects in Construction
Project | Contractor | Value | Completion |
|---|---|---|---|
Prince Albert Victoria Hospital | PCL Construction | $898M (design-build) | Spring 2028 |
Regina LTC Specialized Beds | Graham Design Builders | ~$100M (2026-27) | Fall 2028 |
La Ronge Long-Term Care | Ledcor | Not disclosed | 2027 |
Grenfell Long-Term Care | PCL | Not disclosed | Spring 2027 |
Saskatoon Urgent Care Centre | Ahtahkakoop Cree Developments | Not disclosed | Summer 2026 |
Entering Construction in 2026-27
Project | Key Detail |
|---|---|
Saskatoon Cancer Patient Lodge | 33 private rooms, 14 companion spaces, 3 stem cell transplant suites. Construction spring 2026. |
Royal University Hospital ICU | 19 beds expanding to 26. Design complete, procurement packages planned 2026-27. |
Additional projects in planning include the Yorkton Regional Health Centre (pre-design), urgent care centres in five communities, and complex needs facilities in North Battleford and Moose Jaw.
What It Means For You
PCL holds the two largest named contracts (Prince Albert at $898M, Grenfell LTC). Graham has the Regina LTC. Ledcor has La Ronge. For subcontractors, these four firms are the gateway to Saskatchewan's health capital program.
Health facilities spending peaks in 2026-27 at $472 million and drops to $101 million by 2028-29. The construction window is now. Subcontractors who wait until next year will find the pipeline shrinking.
Health IT and equipment holds steady at $68-90 million annually across the four-year window, a more stable opportunity than the facilities side.
Education: The Wave That's Building
Source: SaskBuilds Major Capital Action Plan | Budget 2026-27
What's Happening

Saskatchewan's education capital is $124 million in 2026-27, a fraction of the health budget. But the four-year trajectory tells a different story: school capital triples to $309 million next year and peaks at $431 million in 2028-29. More than a dozen school projects are in various stages of design and early procurement.
Education Capital Trajectory
Year | School Capital | Maintenance | Total |
|---|---|---|---|
2026-27 | $105.3M | $18.5M | $123.8M |
2027-28 | $309.2M | $18.1M | $327.3M |
2028-29 | $430.9M | $15.5M | $446.4M |
2029-30 | $307.8M | $13.2M | $321.0M |
Quorex Construction holds the two largest school projects currently in construction: Regina Harbour Landing (500 public + 350 Catholic + 90 childcare) and Saskatoon City Centre (350 students + 74 childcare). Swift Current's comprehensive high school renovation is starting in 2026-27 with Quorex as construction manager. Beyond those, 12+ additional school projects are in design or planning stages across the province.
What It Means For You
The education spending pattern is the exact opposite of health. Health peaks now and falls. Education triples over the next two years. Contractors should be positioning for school construction now while the pipeline is still building.
Saskatchewan's school model is joint-use (public and Catholic sharing a facility, with childcare centres). This is the standard template across all new builds.
The design and project management work is flowing now, with Colliers Project Leaders, P3Architecture, and JPH Consulting all named in the Action Plan. Construction awards will follow over the next 12-18 months.
Our Take
The two-wave pattern is the most useful insight in this budget for contractors planning capacity. If you are in health construction, the peak is happening right now. If you are in school construction, the peak is 2028-29 and the procurement process for those projects is just getting underway. Very few provinces give you this kind of visibility into where the spending curve is headed.
Who's Building Saskatchewan
Source: SaskBuilds Action Plan + Publicus BigQuery Data (SaskTenders, 2021-2025)
The Action Plan names the contractors. Our SaskTenders data shows their historical footprint. Here's how the two line up.
Named Contractors: Action Plan vs. Historical Data
Contractor | Action Plan Role | SaskTenders Value (2021-25) | SaskTenders Contracts |
|---|---|---|---|
PCL Construction | PA Hospital ($898M) + Grenfell LTC | $188M | 41 |
Ledcor Group | La Ronge LTC | $89M | 1 |
Quorex Construction | 2 schools + Swift Current CM | $83M | 10 |
Graham Construction | Regina LTC + RSM Museum | $34M | 6 |
These four firms total roughly $394 million in visible SaskTenders data but hold known contracts worth well over $1 billion based on Action Plan disclosures. The gap reflects how SaskTenders captures award notices at milestone stages rather than full lifetime values for multi-year design-build agreements.
For the construction sector more broadly, the SaskTenders leaderboard is dominated by paving and road construction firms.
Top Construction Vendors by SaskTenders Value (2021-2025)
Vendor | Value | Contracts |
|---|---|---|
WestridgeWright Aquatics JV | $245M | 1 |
Potzus Paving | $216M | 17 |
HJR Asphalt | $176M | 43 |
Langenburg Redi-Mix | $168M | 21 |
Venture Construction | $140M | 21 |
Westridge Construction | $126M | 22 |
PCL Construction | $123M | 25 |
Quorex Construction | $78M | 8 |
This makes sense: the $400 million annual highways budget generates steady, high-volume work for paving firms. The institutional builders (PCL, Graham, Quorex) rank lower by SaskTenders volume because their work consists of fewer, individually larger awards.
By the Numbers: How Saskatchewan Buys
Source: Publicus BigQuery Data | SaskTenders 2021-2025
$6.06 billion in 6,204 contracts from roughly 3,700 unique vendors over five years. For context, the 2026-27 capital budget alone ($4.3B) represents 71% of the entire five-year historical spend. The Growth Plan acceleration is real.
Year-over-Year Trend

Year | Contracts | Total Value | Avg Contract |
|---|---|---|---|
2021 | 1,308 | $1.06B | $807K |
2022 | 1,141 | $866M | $759K |
2023 | 1,289 | $1.54B | $1.19M |
2024 | 1,249 | $1.01B | $809K |
2025 | 1,217 | $1.59B | $1.31M |
Contract counts hold steady at roughly 1,200-1,300 per year, but average contract size has grown 62% from $807K (2021) to $1.31M (2025). Projects are getting larger.
Construction and infrastructure accounts for 62% of all historical procurement ($3.76B). IT and technology is 8.7% ($526M). Health and medical is 7.9% ($476M). The budget doubles down on this mix with no signal that the category breakdown is shifting.
RFPs and Invitations to Tender together account for 75% of total procurement value. Advanced Contract Award Notices (the closest proxy for sole-source) represent just 1% at $66 million. Saskatchewan is a competitive market.

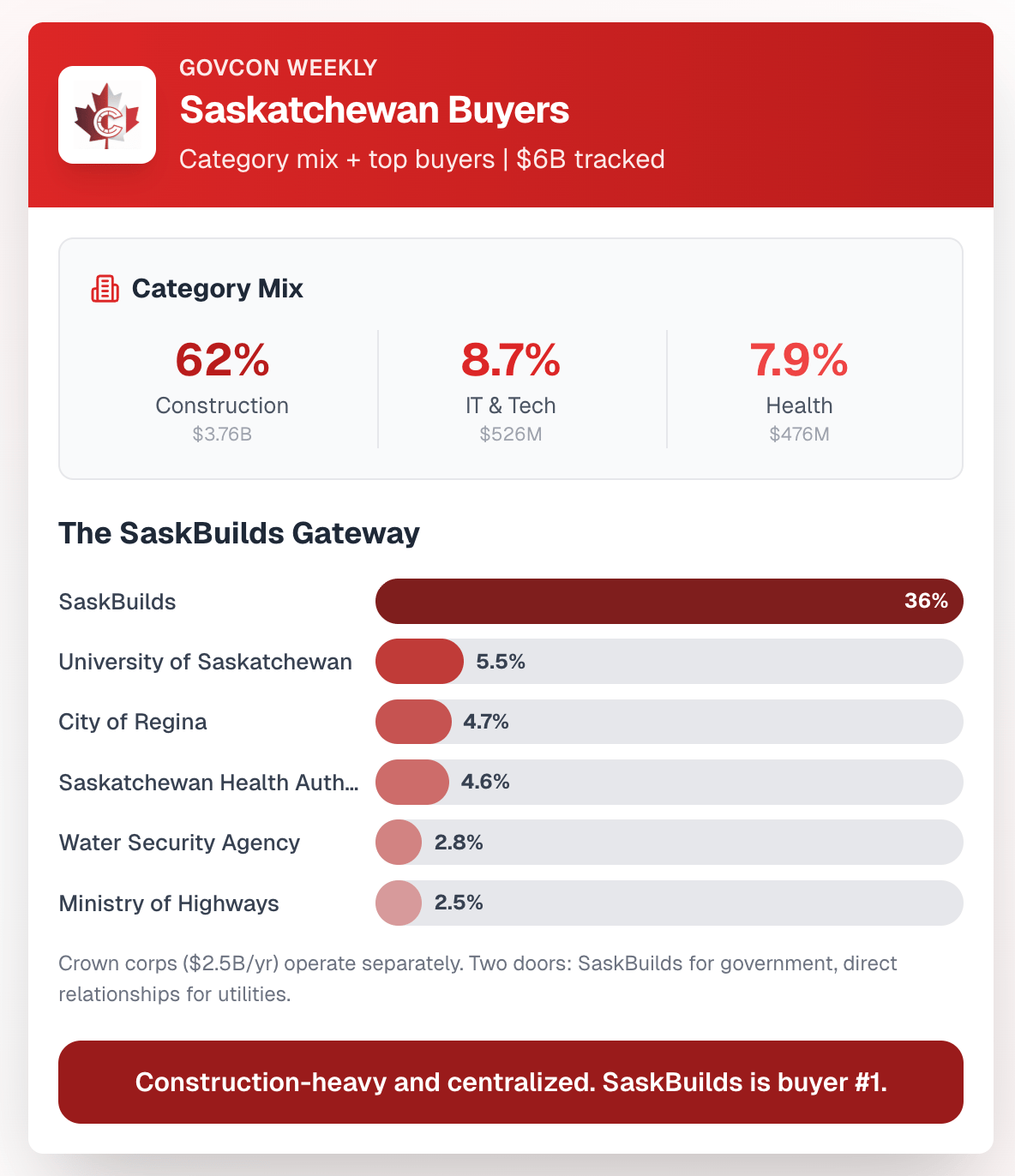

The SaskBuilds Gateway

Buyer | Value | % of Total |
|---|---|---|
SaskBuilds (central procurement) | $2.19B | 36% |
University of Saskatchewan | $331M | 5.5% |
City of Regina | $284M | 4.7% |
Saskatchewan Health Authority | $276M | 4.6% |
Water Security Agency | $168M | 2.8% |
Ministry of Highways | $154M | 2.5% |
eHealth Saskatchewan | $101M | 1.7% |
SaskBuilds coordinates delivery of all major capital projects and accounts for 36% of visible procurement value. If you are selling to Saskatchewan, SaskBuilds is buyer number one. The Crown corporations ($2.5B annually) operate through separate procurement channels, so the practical reality is two doors: SaskBuilds for government, and direct Crown relationships for utilities.
Your Procurement Action Plan
Direct subcontracting BD at PCL, Graham, Ledcor, and Quorex. These four firms hold the majority of named health and education contracts. PCL's Prince Albert hospital alone ($898M with 80%+ yet to be spent) will require mechanical, electrical, medical equipment, and IT integration subcontractors through 2028.
Position for the education construction wave now. School capital triples from $105 million to $309 million next year and peaks at $431 million in 2028-29. Twelve-plus school projects are in design or planning. The procurement processes for those builds will start rolling out over the next 12-18 months.
Build a SaskBuilds relationship if you don't have one. Thirty-six percent of all Saskatchewan procurement value flows through SaskBuilds. For Crown corporation work (SaskPower, SaskTel, SaskEnergy), you will need to engage those entities directly as their procurement is largely separate from SaskTenders.
Watch the highways budget for steady work. Transportation holds at $400-420 million annually across the four-year window, making it the most predictable procurement stream in the province. Twinning projects on Highways 2 and 5 and passing lanes on Highways 10 and 17 are named in the budget.
